Detailed Engineering

Engineered Lower Sidewall Header Repair Avoids a $3–4 Million Replacement

CPE developed and coordinated an excavate-and-repair procedure supported by detailed lower sidewall header stress calculations performed in strict accordance with ASME BPVC Section I. The repair avoided a full replacement estimated at $3–4 million and an estimated 8 to 10 weeks of forced outage.

Project Details

Client

Confidential Independent Power Plant

Year

2023

Project Type

Lower Sidewall Headers Repair

Services Provided

  • Damage mapping based on hardness testing, MT, PT, and UT
  • Detailed header stress calculations per ASME BPVC Section I, with as-built external load considerations
  • Excavation and repair procedure development and on-site coordination
  • NDE review and final engineering approval during repair execution

The Challenge

During a planned shutdown in 2023, a routine inspection identified heat-stress cracking on the fire-facing surfaces of the furnace lower sidewall headers. Additional examination and exploration determined that some cracks were superficial, while others required immediate attention. Because of the depth of some cracks, the unit would have to remain down until the repair was completed.

The initial plan was to source the lower header material, fabricate new headers, and install them. Though the header was a custom schedule (wall thickness), the header material was located in distributor inventory, but the fabrication cost and schedule remained high.

Expedited fabrication of new headers would have cost more than $1.5 million and taken 3 to 4 weeks to arrive to site. Full replacement would also have required removing structural steel, connecting piping, ductwork, and refractory. The total replacement cost was estimated at $3 to $4 million, not including lost revenue while the unit was down.

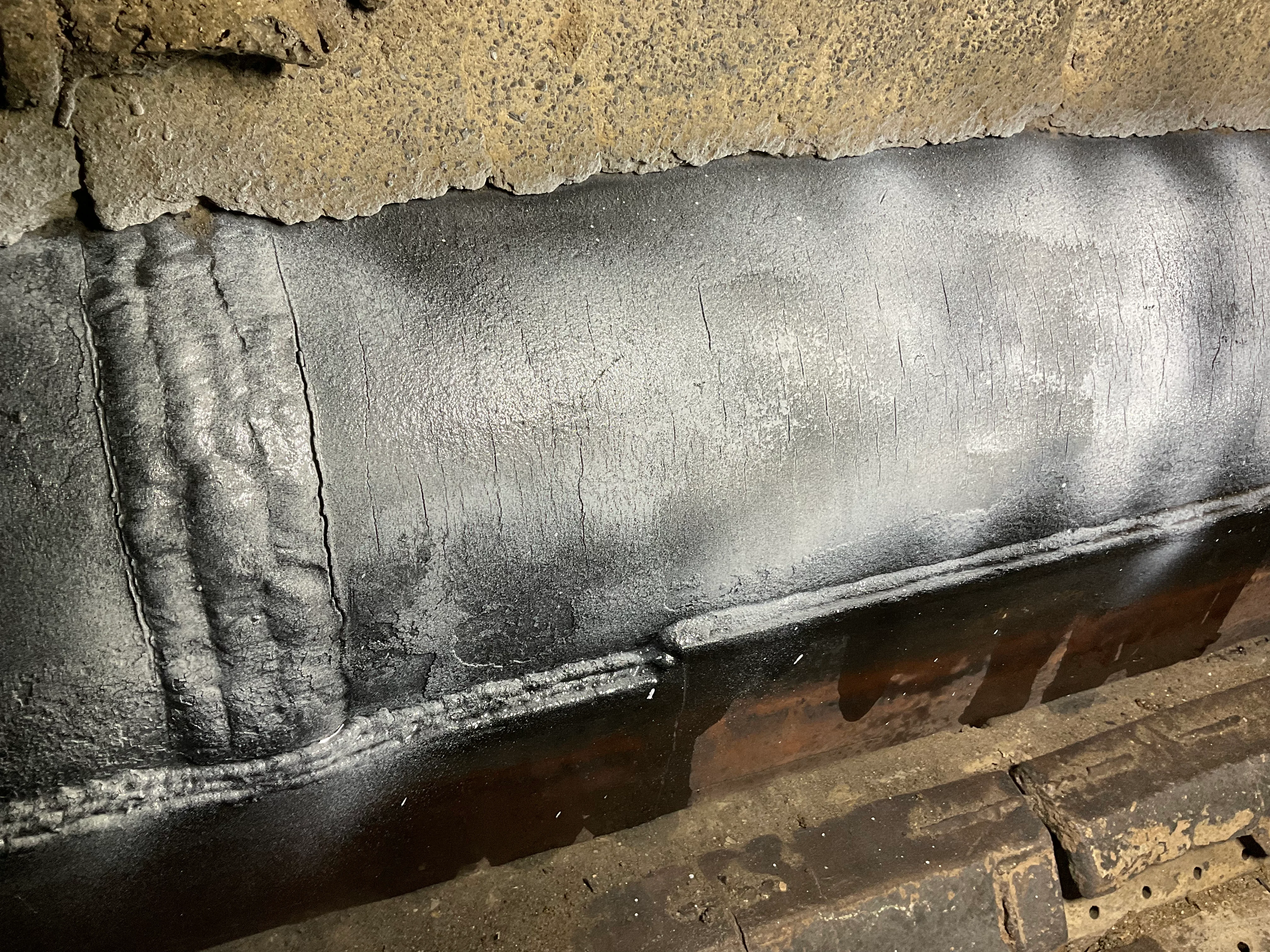

Cracking on the fire-facing surface of a furnace lower sidewall header
Damaged condition observed during the planned shutdown.

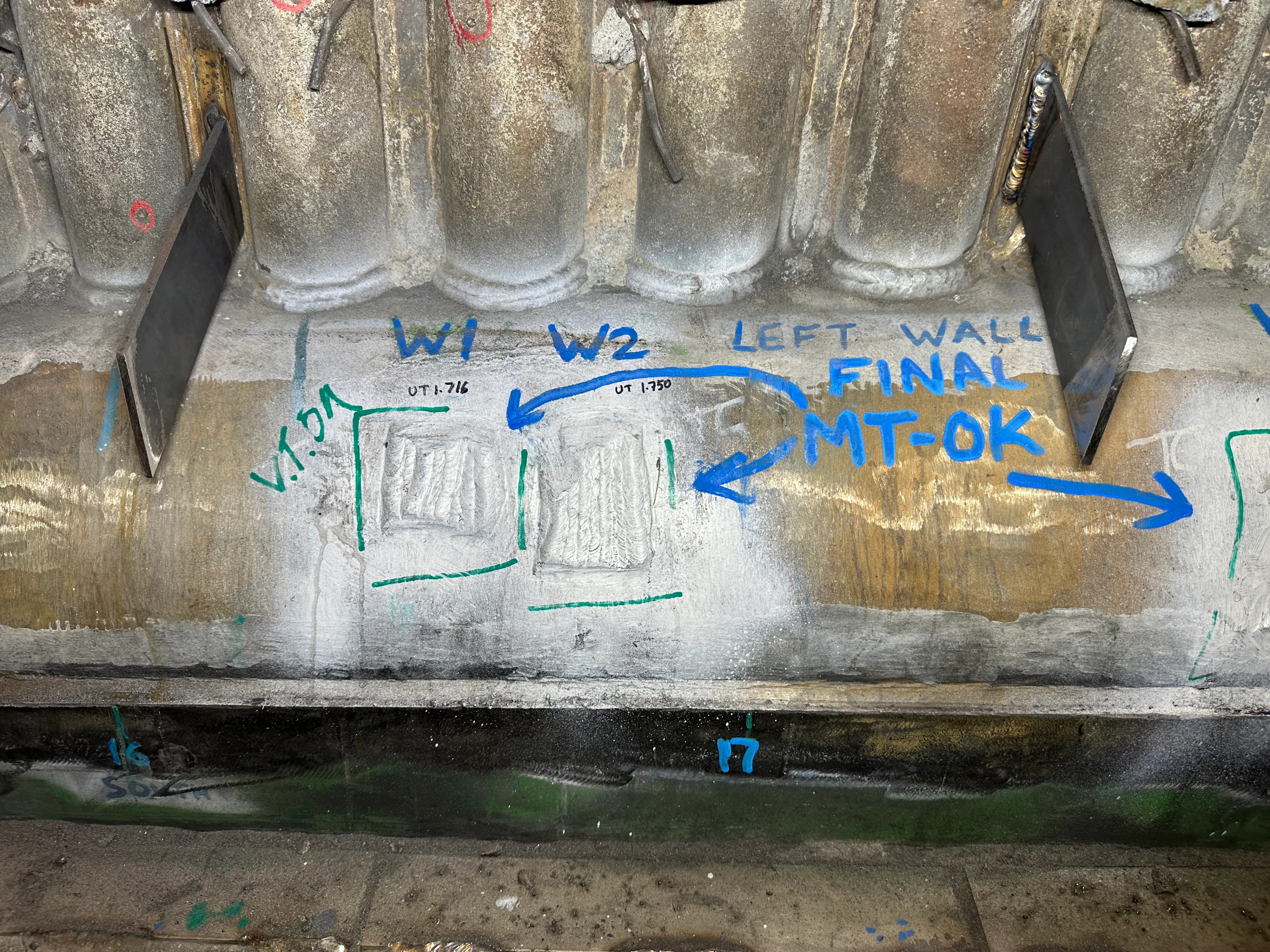

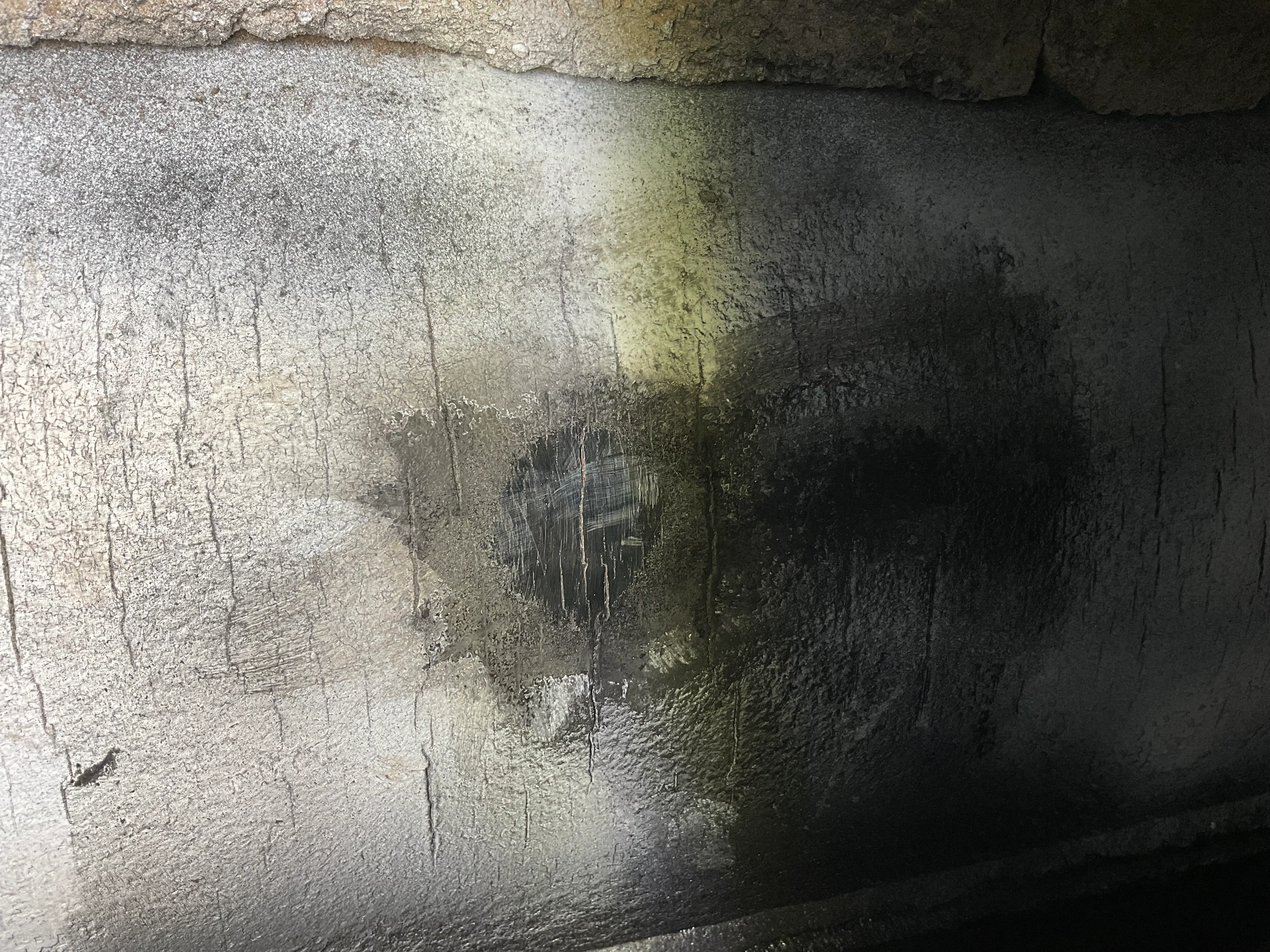

Close-up of heat-stress cracking on a furnace lower sidewall header

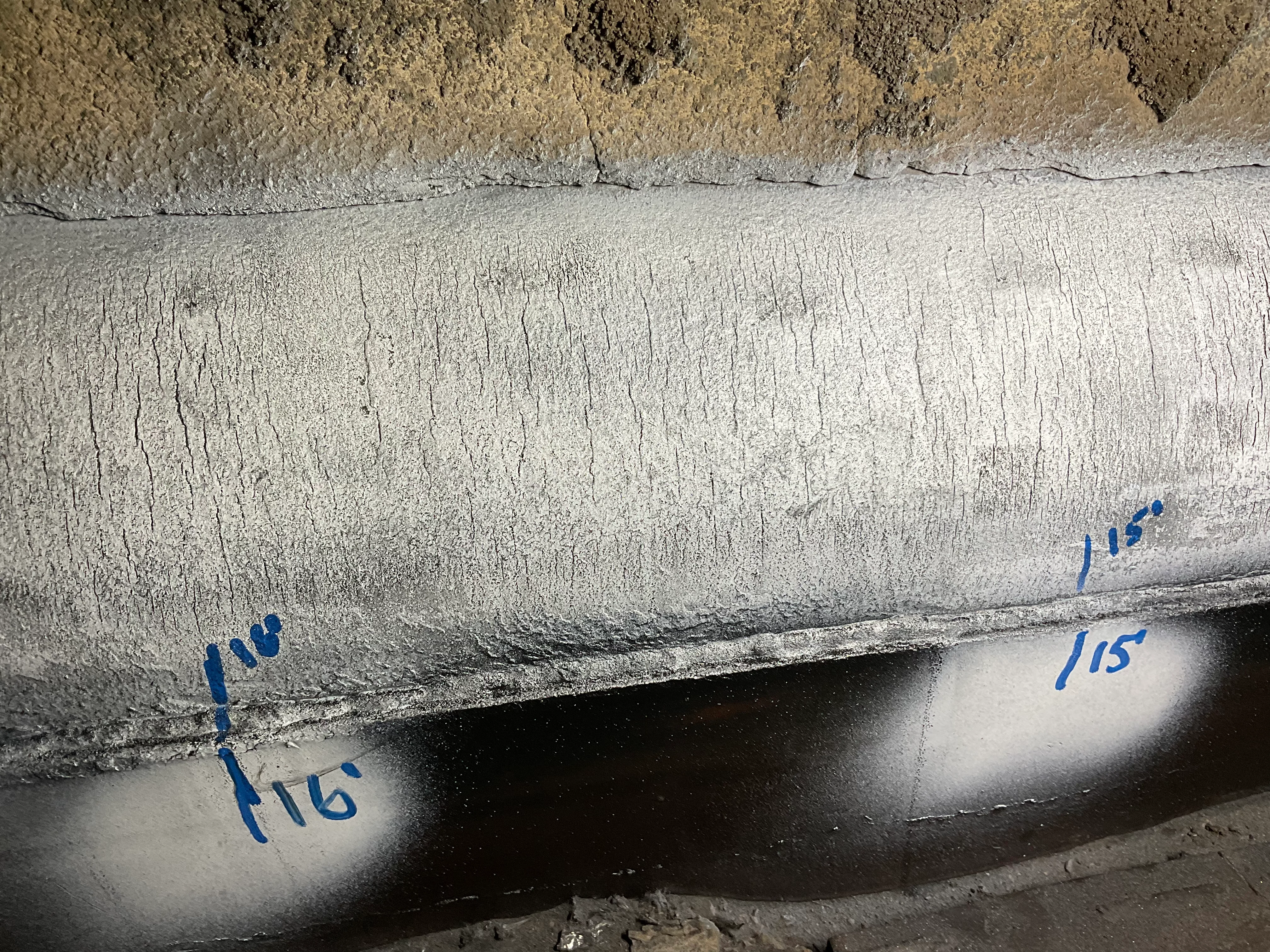

Mapped cracking and inspection markings on a furnace lower sidewall header

Additional views of the damaged condition.

Damage Mapping, Stress Analysis, and Coordinated Repair

CPE worked with the plant management team, its subcontracted boilermakers, and the non-destructive examination (NDE) team to perform detailed mapping of the heat damage and establish a safe and reliable alternative to full header replacement. The work combined multiple NDE methods with detailed header stress calculations and a coordinated field repair procedure.

Damage Mapping and NDE Coordination

Performed detailed mapping of the heat-damaged areas using hardness testing, magnetic particle inspection (MT), dye penetrant testing (PT), and ultrasonic thickness testing (UT).

Proposed and Developed Engineered Repair Procedure

CPE proposed an excavate-test-repair-test procedure and coordinated it with the site team - concept to final acceptance.

Header Stress Engineering

Performed detailed header stress calculations per ASME BPVC Section I to determine the minimum allowable thickness in circumferential and longitudinal coordinates, accounting for areas of reinforcement, ligament efficiencies, and external header mechanical loads.

Reinforcement and Load Analysis

Engineering review on reinforcement requirements and the mechanical and structural loads from the installed assembly.

Final Acceptance

CPE provided final engineering acceptance of the repaired headers based on visual inspection (VT), MT, PT, and UT.

Returned to Service Without Full Header Replacement

The subcontracted boilermakers staffed up to excavate and repair the lower sidewall headers around the clock, with NDE performed directly behind the repair work and final engineering review and approval.

The unit returned to service several days after the originally scheduled startup. Although the repair procedure increased shutdown expenditure and delayed startup by several days, it avoided an estimated 8 to 10 weeks of forced outage and millions of dollars.

8 to 10 weeks

Estimated forced outage avoided

Compared with the full header replacement path.

$3–4 million

Estimated full replacement cost

Excluded lost revenue while the unit was down.

3 years

Annual inspections completed

Condition remains consistent with the post-repair state.

Follow-Up Inspection History

The lower headers have been inspected annually for the past three years. The repaired header remains in the condition documented when the unit returned to service following the repairs.

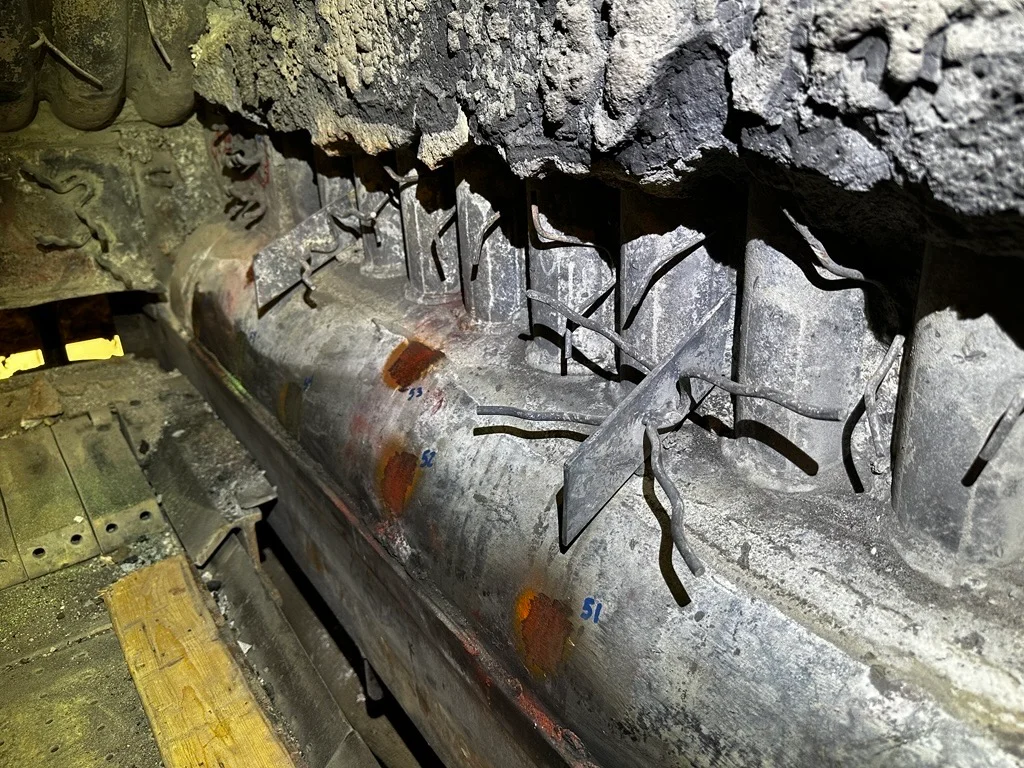

Lower sidewall header during follow-up inspection one year after repair
